Design: Summer 2017
Bid Process: Summer/Fall 2017
Construction: Fall 2017 - Summer 2018 (complete)
UPDATES:
June, 2018 - Construction of the pre-ag classroom is complete.
February, 2018 - Construction of a pre-ag classroom is 95% complete and media center technology updates are complete.
December, 2017 - Construction of a pre-ag classroom is 80% complete. The mechanical, electrical, and plumbing preparation is nearly complete.

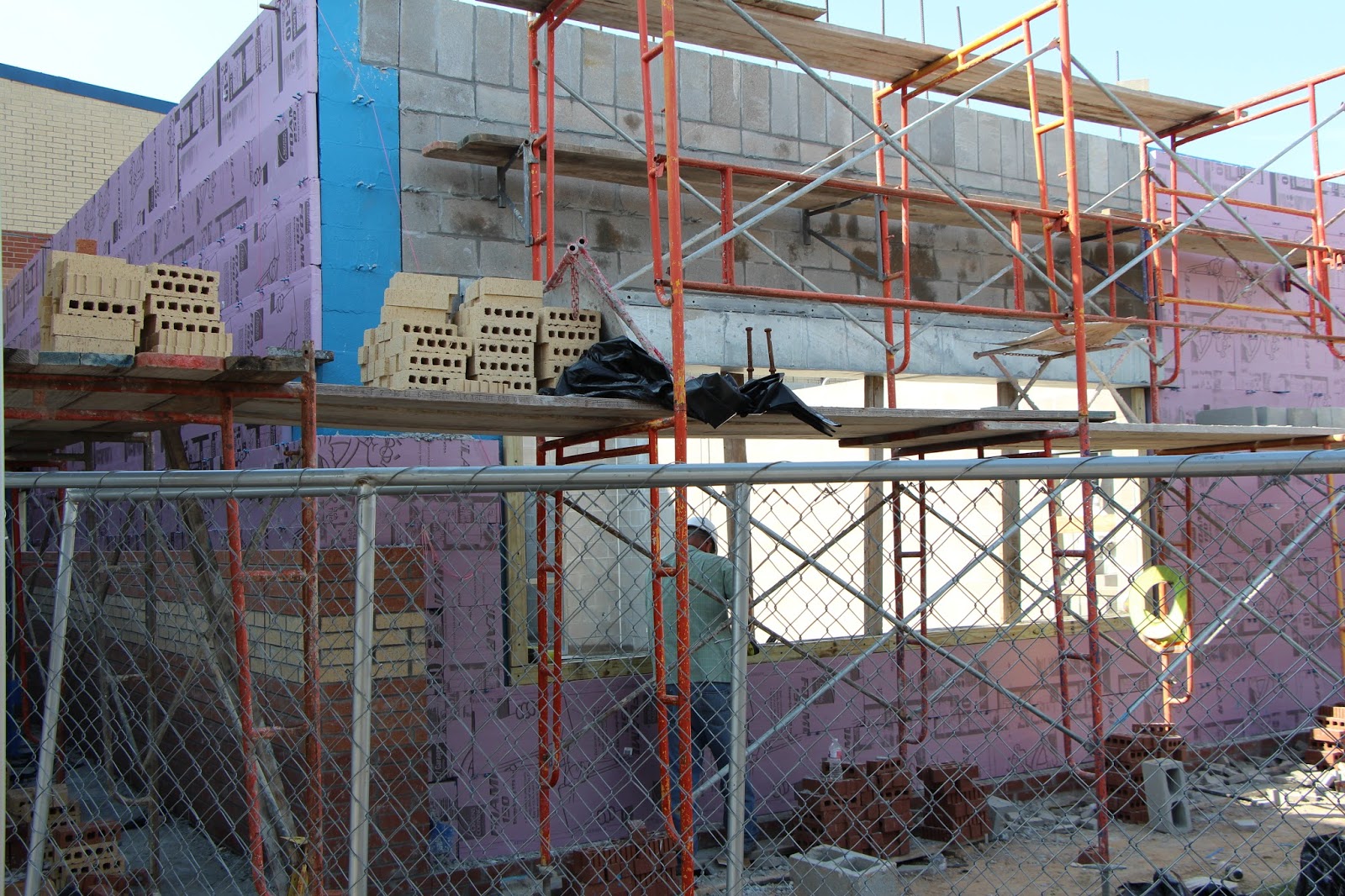

September, 2017 - Construction of a pre-ag classroom is 40% complete. The foundation is complete and structural steel is done. Masonry work is 80% complete. Interior renovation for fire alarm systems is 20% complete.
July, 2017 - Construction of a pre-ag classroom addition began this month. The foundation is approximately 50% complete.
March, 2017 - The design phase for a pre-ag classroom addition and other life cycle items has begun at White Oak Middle School.
Project: Field House
Design: Summer 2015
Bid Process: Summer/Fall 2015
Construction: Fall 2015 - Summer 2016 (complete)
UPDATES:
August, 2016 - NCISD Director of Facility Planning and Construction Richard Gates reported to the Board at its August regular meeting that construction of the field house at White Oak Middle School is complete.

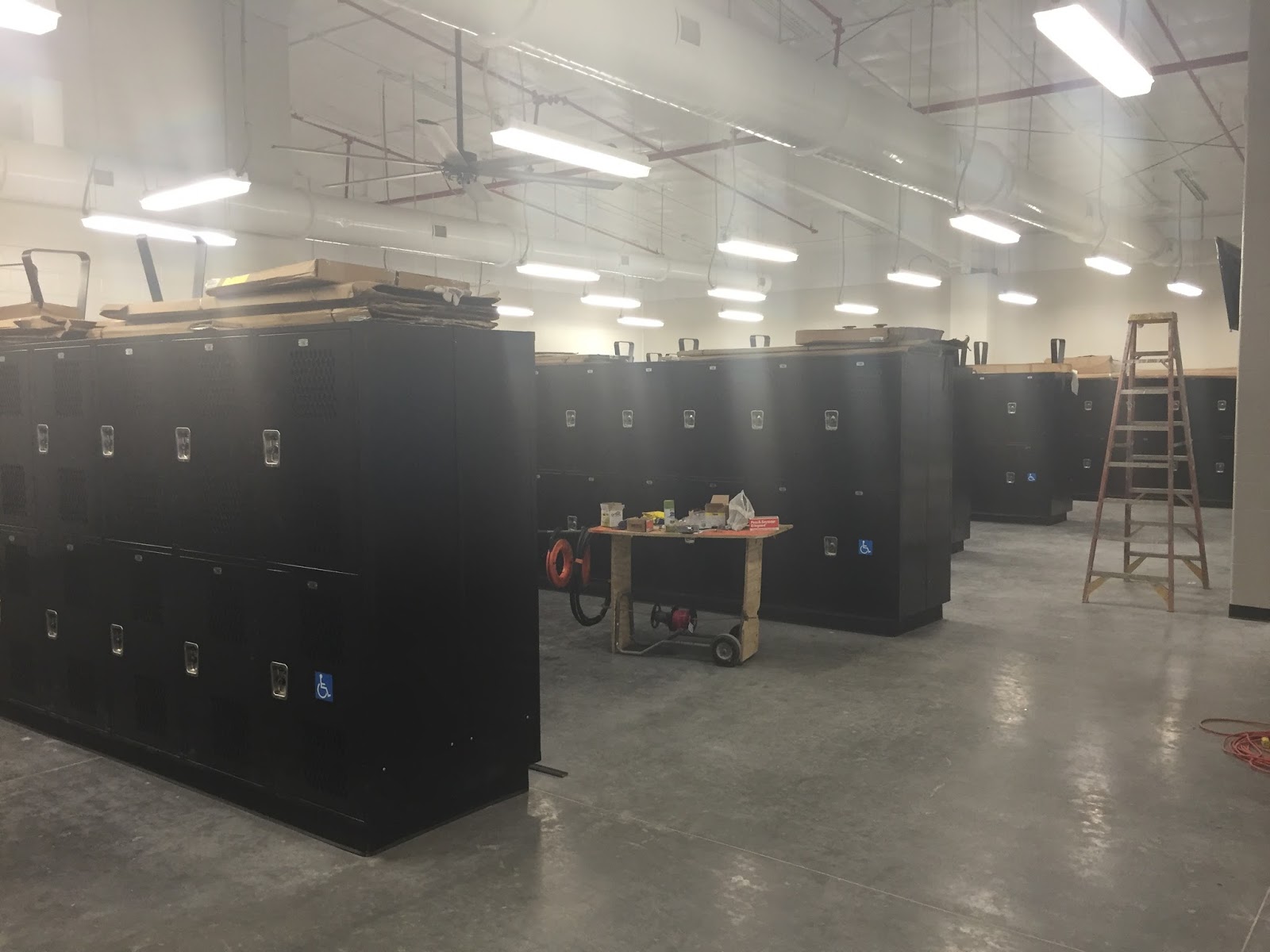

July, 2016 - NCISD Director of Facility Planning and Construction Richard Gates reported to the Board at its July regular meeting that the construction of a field house at White Oak Middle School is 98% complete.
June, 2016 - NCISD Director of Facility Planning and Construction Richard Gates reported to the Board at its June regular meeting that construction of the field house at White Oak Middle School is 90% complete and is expected to finish up in July.
May, 2016 - NCISD Director of Facility Planning and Construction Richard Gates reported to the Board at hits May regular meeting that the field house at White Oak Middle School is on time and scheduled to be complete this summer.
March, 2016 - NCISD Director of Facility Planning and Construction Richard Gates reported to the Board that the field house at White Oak Middle School is approximately 65% complete. The project is on time and scheduled to be complete this summer.
February, 2016 - NCISD Director of Facility Planning and Construction Richard Gates reported to the Board that the field house at White Oak Middle School is now dried in and interior work will continue through the spring. The project is on time and scheduled to be complete this summer.
December, 2015 - NCISD Director of Facility Planning and Construction Richard Gates reported to the Board of Trustees at its December 14, 2015 meeting that work was continuing as scheduled on the field house at White Oak Middle School.
November, 2015 - NCISD Director of Facility Planning and Construction Richard Gates reported to the Board of Trustees at its November 16, 2015 meeting that work was continuing on the field house at White Oak Middle School. Gates said workers would begin underground plumbing and laying the slab soon.
October, 2015 - NCISD Director of Facility Planning and Construction Richard Gates reported to the Board of Trustees at its October 19, 2015 meeting that work had begun on the field house at White Oak Middle School.
September, 2015 - The New Caney ISD Board of Trustees approved a construction contract with Purcell Construction for the proposed field house at White Oak Middle School at its regular meeting Sept. 21. Construction at White Oak is scheduled to begin during the fall semester.
June, 2015 - Work on a field house for White Oak Middle School is planned to occur in the first phase of projects associated with the 2015 bond election. Project timeline dates are set for planning and project-management purposes and may be adjusted in response to changing circumstances as work progresses.
- Design: Summer 2015
- Bid Process: Summer/Fall 2015
- Construction: Fall 2015 - Summer 2016
